VPP Policy Map

A structured map of the state VPP policy landscape.

Every rule a state needs to write to enable virtual power plants, organized into one framework, mapped as content, and built into a tool regulators can navigate.

Free to use for state commissions and energy offices.

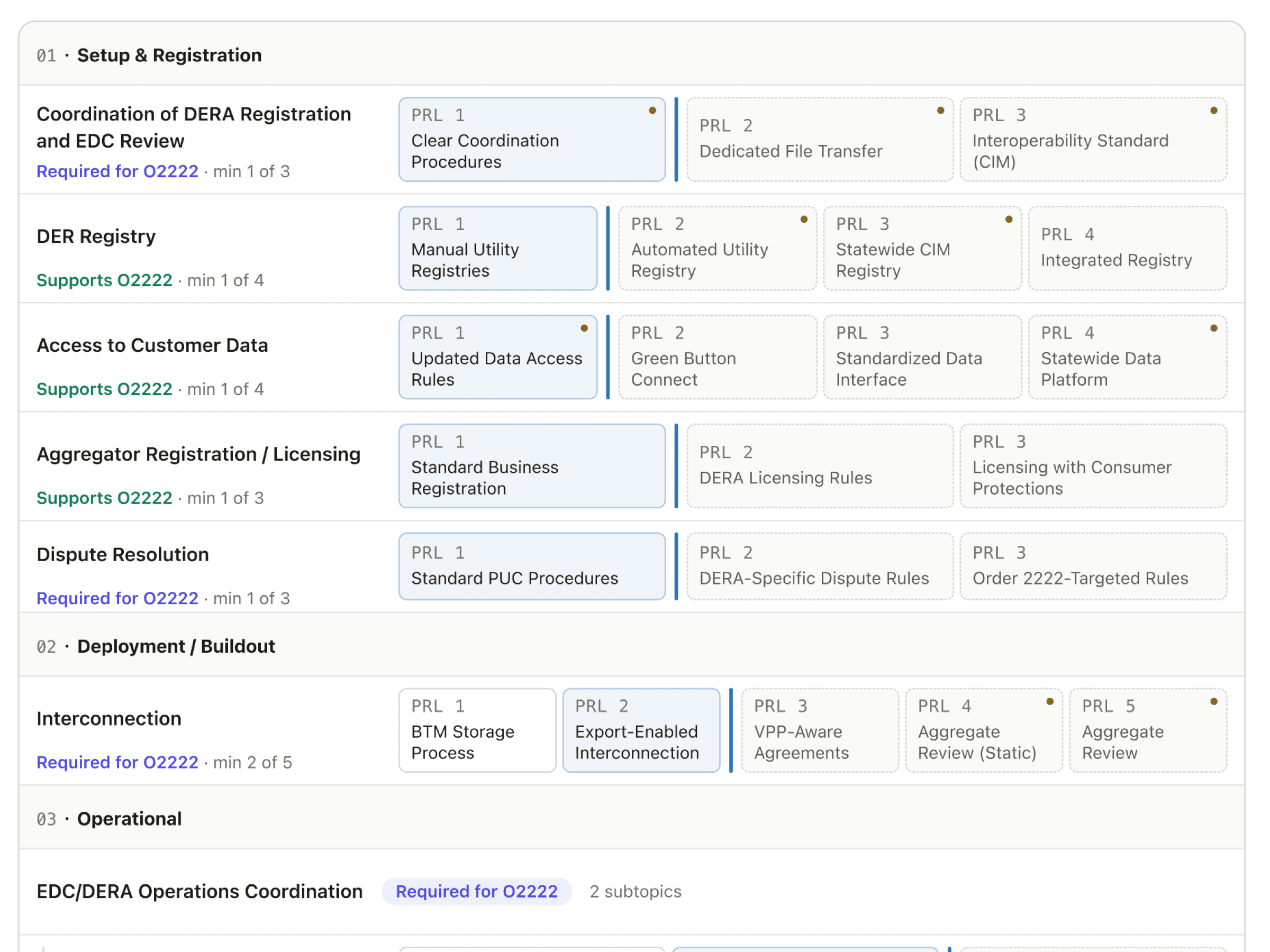

The VPP Policy Navigator matrix view: the full topic grid for FERC 2222: PJM with minimums marked

The problem

States are writing the rules for virtual power plants. Nobody gave them a map.

Say a state wants the batteries and smart thermostats in people's homes to sell power into the regional market. That one goal touches a dozen policy topics, each with its own docket, stakeholders, and history. Most commissions are working through it with a handful of staff and no structured way to see what is done and what is missing.

FERC Order 2222 made this urgent. Every state in a participating regional market now has to write these rules. The research to do it exists, spread across dozens of organizations. What doesn't exist is a structured way to see which rules a state already has, which ones it still needs, and what other states have done.

The Framework

One way to organize every VPP rule a state might write.

The VPP Policy Framework sorts the rules into policy topics, groups the topics into four categories, and breaks each topic into a ladder of Policy Readiness Levels. A level is an observable regulatory condition: a rule that exists, a process that has been established, a standard that has been adopted.

Policy Readiness Levels were developed with VPP companies, grid operators, policy experts, and state regulatory staff, and each one is drawn from regulatory precedent.

Deployment / Buildout

Interconnection

  1. PRL 1

    BTM Storage Process

    States set and require a BTM storage interconnection process (distinct from solar), non-exporting.

  2. PRL 2

    Export-Enabled InterconnectionMinimum for FERC 2222: PJM States

    DER interconnection regulations allow batteries and EVs to export to the grid.

  3. Further development

  4. PRL 3

    VPP-Aware Agreements

    State and local regulators incorporate additional rules into interconnection agreements, such as flexible interconnection, communications protocols, dispatch override requirements, and reviewing static limit impacts for DERs.

  5. PRL 4

    Aggregate Review (Static)

    Updating DER interconnection processes to include the review of aggregate impact of DERAs and VPPs using static conditions.

  6. PRL 5

    Aggregate Review (Dynamic)

    Updated DER interconnection processes include the review of aggregate impact of DERAs using dynamic conditions.

Levels order the milestones within a topic. They are not comparable across topics, and a higher level is not inherently better; readiness is relative to what a Guide requires.

The Map

12 policy topics. 4 categories. 47 regulatory milestones.

The initial VPP Policy Map shows the content needed to implement wholesale market VPPs under FERC Order 2222: every topic, every level, and the regulatory precedent behind each one, drawn from proceedings and rules that states have already put on the record.

Setup & Registration

Coordination of DERA Registration and EDC Review3 levels
DER Registry4 levels
Access to Customer Data4 levels
Aggregator Registration / Licensing3 levels
Dispute Resolution3 levels

Deployment / Buildout

Interconnection5 levels

Operational

EDC/DERA Operations Coordination6 levels
Communications Protocols3 levels
Dispatch Override6 levels

Markets / Transactions

Grid Services Authorization3 levels
Metering3 levels
Dual Participation4 levels

Developed in collaboration with VPP companies, grid operators, policy experts, and regulatory staff across fifteen-plus states.

The Navigator

How you move through the Map.

The VPP Policy Navigator is the tool. It starts from a scenario regulators recognize and shows exactly which decisions their state needs to make.

  1. Step 1

    Start from a Guide.

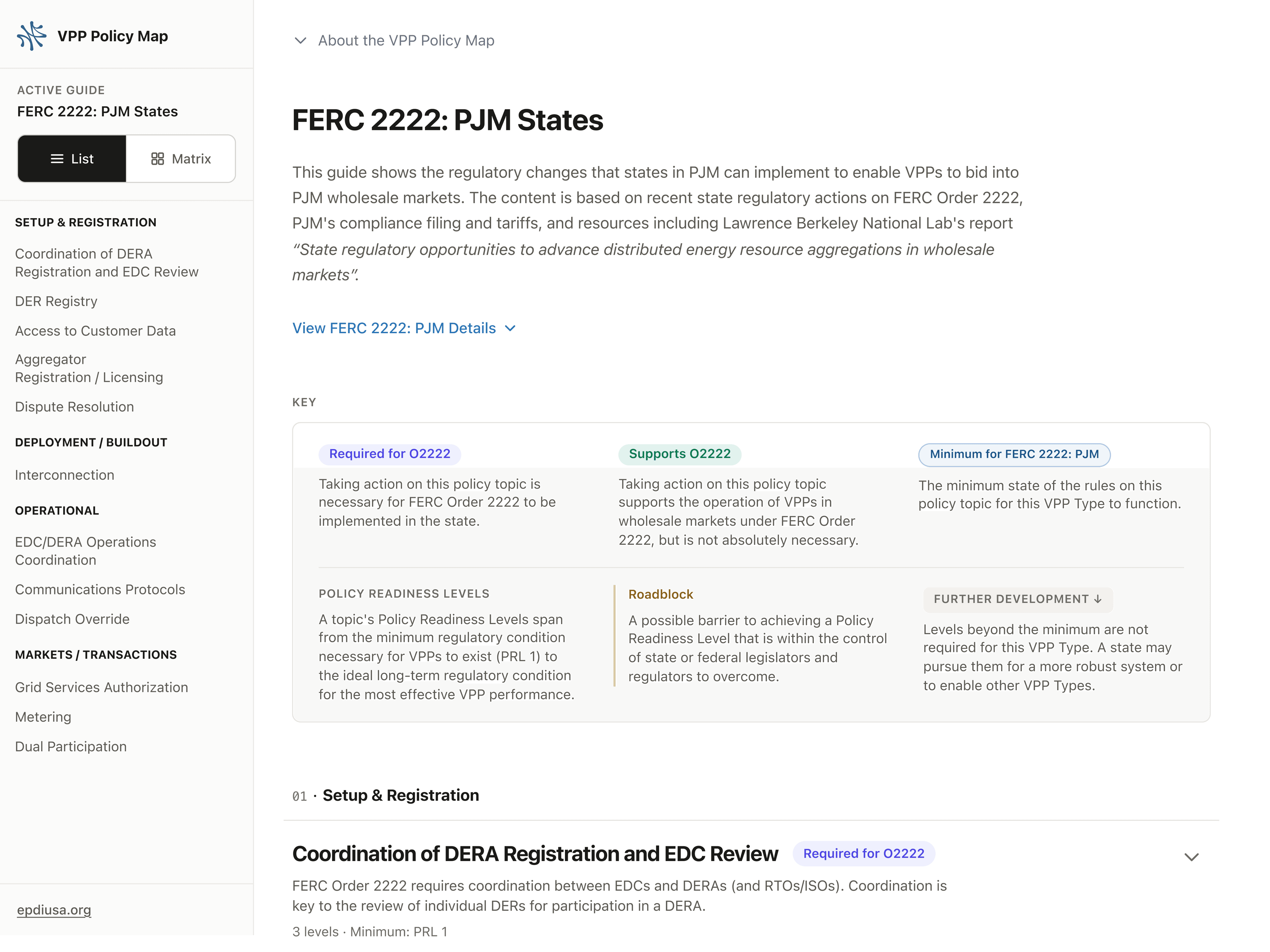

    Each Readiness Guide covers one scenario. The first covers what a state in the PJM market needs so that aggregated resources can participate under FERC Order 2222. A key explains which topics are required, which support the scenario, and where the minimum sits.

    The FERC 2222: PJM States Readiness Guide header, with the key explaining required and supporting topics and the minimum
  2. Step 2

    See the whole map at once.

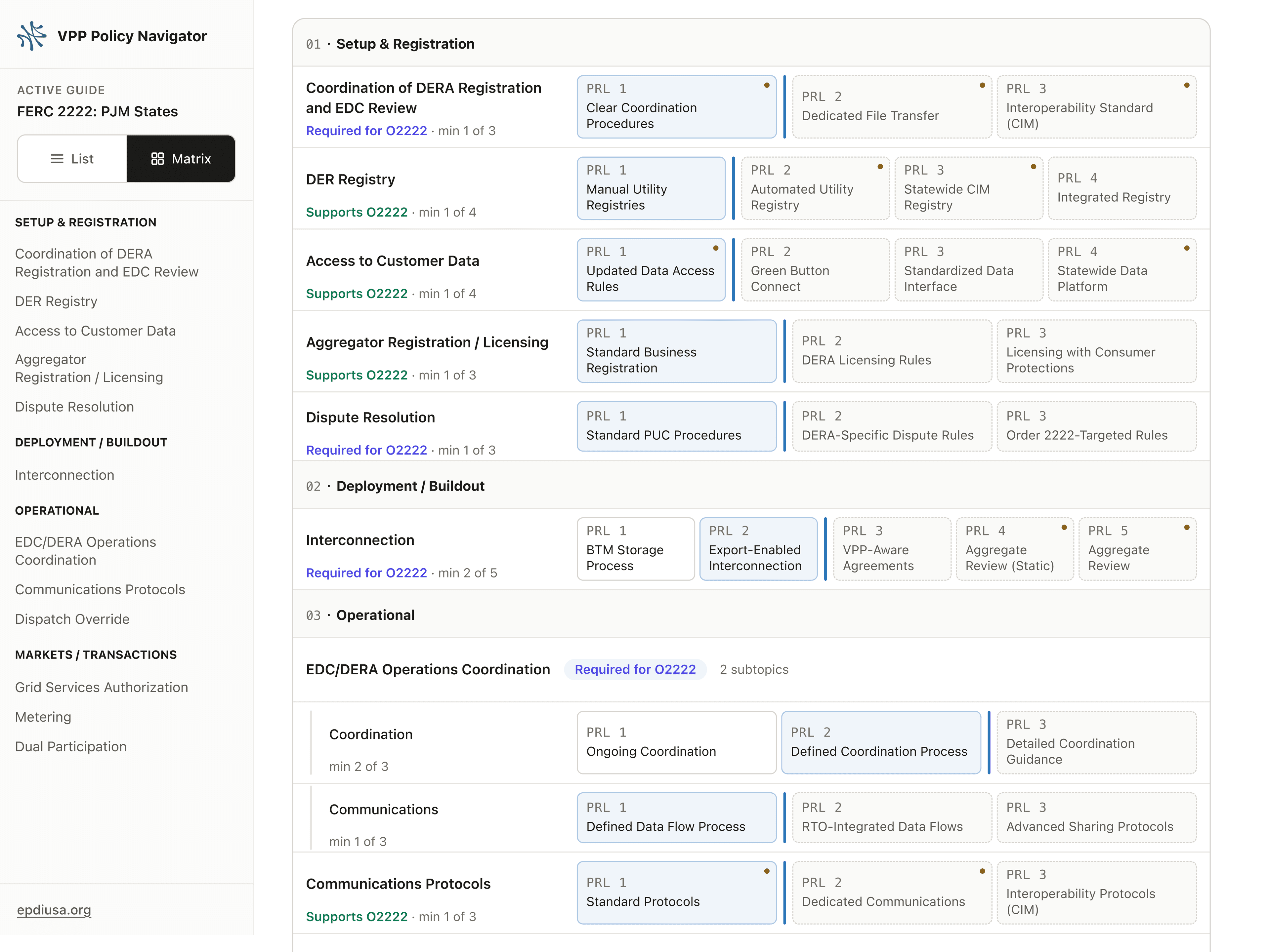

    The matrix view lays out every topic and every Policy Readiness Level on one screen, with the minimum for the Guide marked. Regulators and their staff can see where the work is in one picture.

    The Navigator matrix view: every topic and level on one screen, Setup & Registration through Markets / Transactions, with the Guide minimum marked
  3. Step 3

    Open a topic. Read the milestones.

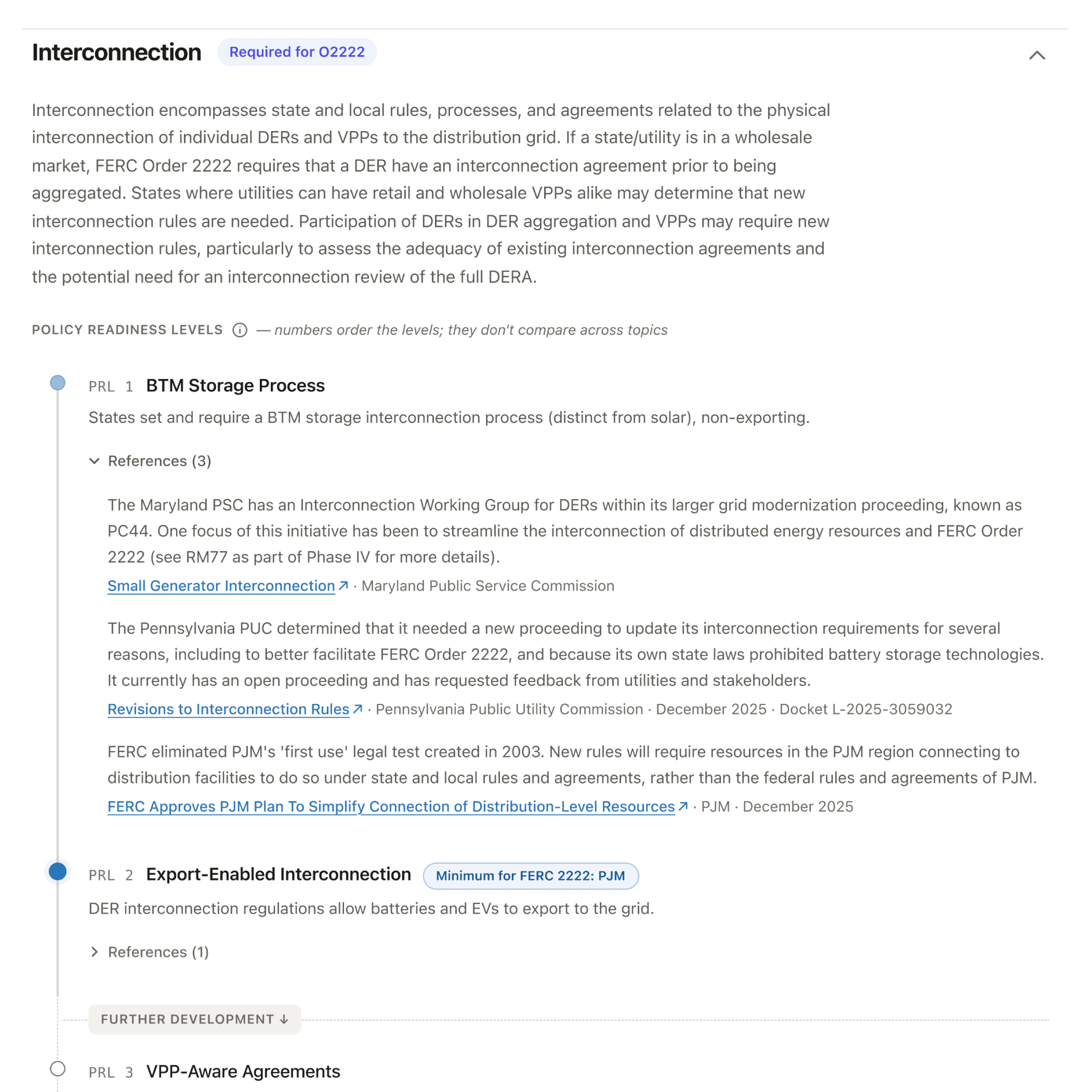

    The list view expands each topic into its ladder: what each level means, the roadblocks along the way, and the sources it draws from.

    The Navigator list view with Interconnection expanded: the full ladder with the minimum, a roadblock, and sources in frame

What the Framework makes possible

You Are Here: Virginia

Because every level is an observable condition, a state can be assessed against the Map. This view is distilled from EPDI's work with Virginia's DER Task Force: it shows where the state stands on each policy topic.

Order issued
Cybersecurity
DER cybersecurity standards due within 18 months of the June 2026 order.
Docket active
Interconnection
Two working groups active; no VPP interconnection rules adopted.
Docket active
Access to Customer Data
Access directed by 2025 legislation; the Commission has not yet acted.
Docket active
Dual Participation
No VPP-specific rules; NEM and demand-side management rules presumed to apply.
Pilot activity
Coordination of DER Registration and EDC Review
No regulations; procedures set program by program.
Pilot activity
Dispute Resolution
Interconnection disputes covered; none for utility–aggregator disputes.
No activity
Metering
No VPP metering rules; sub-metering is the open question.
No activity
Dispatch Override
No rules on utility override of VPP dispatches.

State assessments are on the Navigator roadmap. Today they are delivered as reports; in the tool, a state will see its position on every ladder.
